21A TAC Report

Summary

A total of 235 proposals were submitted to NRAO's North American facilities for semester 21A.  These include the Very Long Baseline Array (VLBA)/High Sensitivity Array (HSA) and the Karl G. Jansky Very Large Array (VLA).  Proposals are reviewed on a competitive basis with a panel review system (see Proposal Review System).  Below are the statistics by proposal count and hours.  The oversubscription is the ratio of the number of submitted proposals to the number of approved proposals.  The pressure is the ratio of the requested time to the available time in hours.  Here we only include proposals submitted for the 21A semester that have been reviewed by the NRAO TAC.  We count HSA proposal hours that request the VLA as a VLBI station.

Statistics by Proposal Count
ProposalsVLBAVLA
Submitted 41 194
Approved 15  79
Filler   8  58
Rejected 18  57
Oversubscription 2.7 2.5

Statistics by Proposal Hours
ProposalsVLBAVLA (D)VLA (C)
Requested   1634.07 2764.49 3075.72
Available     450.88 1308.00 1598.00
Approved     570.62  991.69 1354.45
Filler     290.27  517.66 1035.40
Rejected     773.18 1208.64  605.96
Pressure       3.6     2.1     1.9

For the 21A semester, the NRAO had agreements with the Hubble Space Telescope (HST), the Swift Gamma-Ray Burst Mission, the Chandra X-ray Observatory, and the XMM-Newton Telescope to submit joint proposals whereby the NRAO TAC could allocate time on these external facilities (see the 21A Call for Proposals).   The table below summarizes the results for all AUI North American facilities that are included in the joint program: GBT, VLBA, and VLA.  The time available on the external facilities is per year, whereas the time requested and approved is only for semester 21A.

Joint External Proposals

HST (Orbits)

Swift (ks)Chandra (ks)XMM-Newton (ks)

Available

30.0 300.0 120.0 150.0
Requested 52.0  119.0    30.0    0.0
Approved  9.0   39.0     0.0    0.0

Telescope Pressure Plots

Pressure plots show the total hours of allocated time as a function of LST (or GST).   Also shown are how the hours are divided with respect to weather conditions and observing priority.  Click on the plot to enlarge

VLBA

VLBA pressure plot as a function of GST. The black line with squares is 52% of the wall-clock time available (after removing time for maintenance and sponsored time). Note that the approximate Pie Town LST is shown on the top axis. The colors correspond to pre-committed time (green), priority A (dark blue), priority B (light blue), priority C (yellow), and priority N (red).

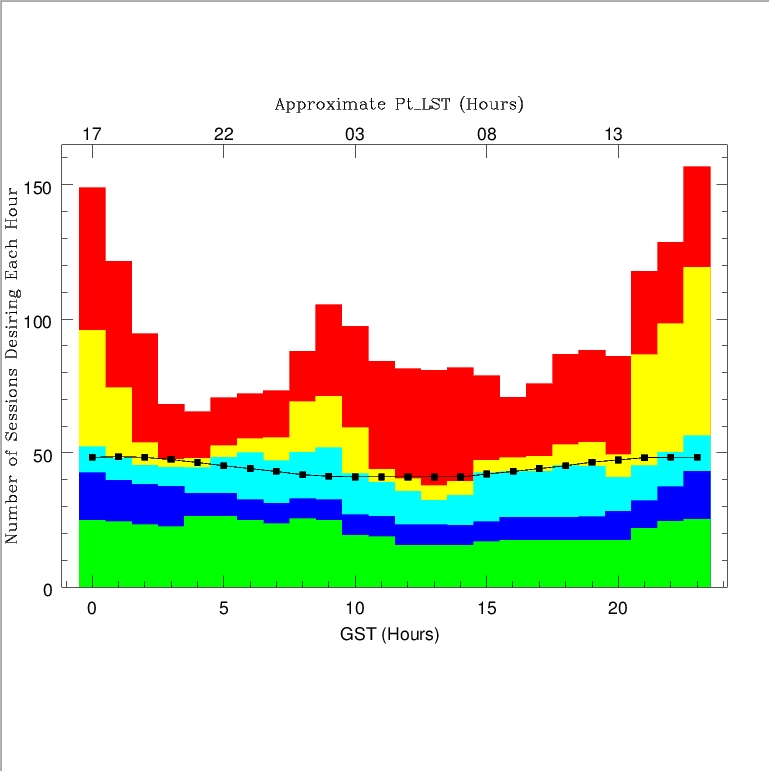

VLBA Pressure Plot 21A

VLA

VLA Pressure plots as a function of LST. The VLA has two weather categories: high frequency (above 12 GHz, light shading) and low frequency (below 12 GHz, dark shading). The figure below shows the pressure for the D and C-configurations.  The black lines indicate the total time available for science (solid), the time available for K-band and higher frequencies (dashed), and the time available for Q-band (dotted).  The letters A, B, C, and N correspond to the priorities assigned by the TAC where A and B are approved time, C is filler time, and N is rejected time.

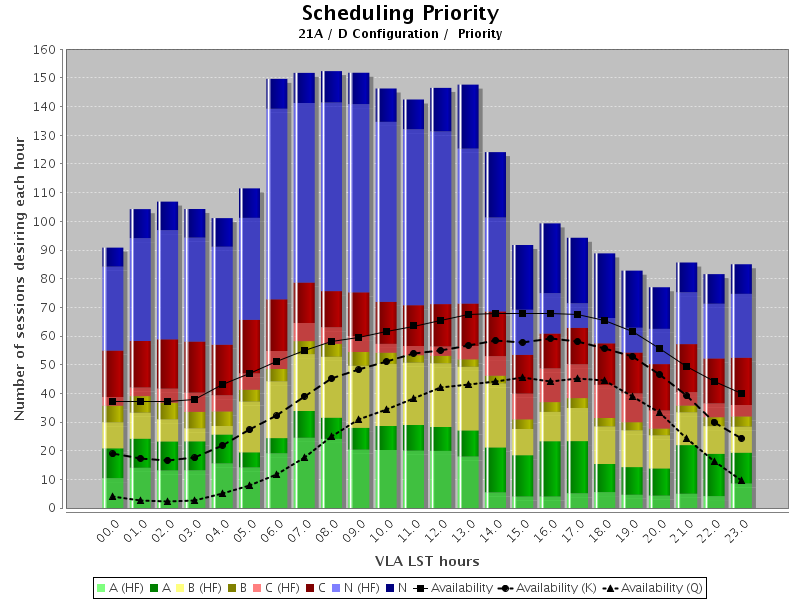

 VLA Pressure Plot 21A (D)

VLA Pressure Plot 21A (C)

Observation Preparation

VLBA

Unless otherwise stated in the TAC comments, proposals approved for priority A time will be eligible for scheduling in semesters 21A and 21B, and proposals approved for priority B or C time will be eligible for scheduling only during semester 21A.

IMPORTANT: Those observers allocated dynamic time on the VLBA must either submit their schedule (.key) files (to vlbiobs@nrao.edu) before the beginning of the semester (2021 February 1), or contact the VLBA scheduler before that date to avoid a reduction in scheduling priority.  Completed observing files, or preliminary ones, should be sent to the data analysts at vlbiobs@nrao.edu, for checking and possible iteration.  Those proposals with fixed-date allocations (e.g. HSA proposals) will be informed of the date/time of observation about one month prior and their schedules will be due two weeks prior to observation.

IMPORTANT: Observers are cautioned that daily observations by the United States Naval Observatory (USNO) using three stations of the VLBA (generally Sc, Pt, and Mk) can interrupt open-skies observations at those stations for approximately 1 hour (see the daily-ut1 web page for further details).

Any approved time tabulated above may be divided into multiple scheduling blocks as appropriate, considering the scheduling priority, observing frequency, GST range suitable for the target(s), and GST pressure. For advice on preparing your scheduling blocks, please consult the VLBA Observing Guide or use the helpdesk.

VLA

Unless otherwise stated in the TAC comments, proposals approved for priority A, B or C time become ineligible when the associated configuration ends.

IMPORTANT: Users granted dynamic, non-triggered time, must either submit their scheduling blocks (SBs) before the start of the configuration or contact the VLA  Scheduler (schedsoc@nrao.edu) before that date to avoid a reduction in  scheduling priority. Early submission also maximizes the opportunity of SBs  being observed and helps us to schedule the VLA most efficiently (see Configuration Plans).

In semester 21A, daytime maintenance activities peak at about 01 hours and 09 hours LST for the D and C-configuration, respectively, so observing pressure is highest there. For status of the VLA and links to the monthly schedules please see the schedsoc home page.  Any approved time may be divided into multiple scheduling blocks as appropriate, considering the scheduling priority, observing frequency, LST range suitable for the target(s), and LST pressure.  In order to optimize the likelihood that the project will be completed, proposers should try to maximize the LST range SBs can be observed within the approved LST range. For advice, please consult the VLA Observing Guide.

Unless stated otherwise, any time allocated is only for the identified proposal, and no modification in the project should be made without obtaining permission from NRAO scheduling staff.  To seek permission, submit a ticket to the Proposal Review department of the NRAO Helpdesk.
